loading

Tailored Camp Solutions to Meet  Custom Needs.

Tropical Climate Modular Mining Camp Design for Indonesia: Fast-Deploy Container Dormitories with Heat-Resistant Solutions

WELLCAMP’s container-based modular dormitories are engineered specifically for Indonesia’s tropical mining zones, where ambient temperatures regularly exceed 35°C and relative humidity stays above 80%. Their systems integrate galvanized steel frames with 1.2 mm anti-corrosion coating, 50 mm rock wool insulation, and heat-reflective roofing that reduces internal surface temperature by up to 12°C compared to standard containers. Deployable in under 7 days and compliant with Indonesian SNI 03-6481-2000 for temporary structures, these camps have supported over 12 remote site deployments across Kalimantan since 2019.

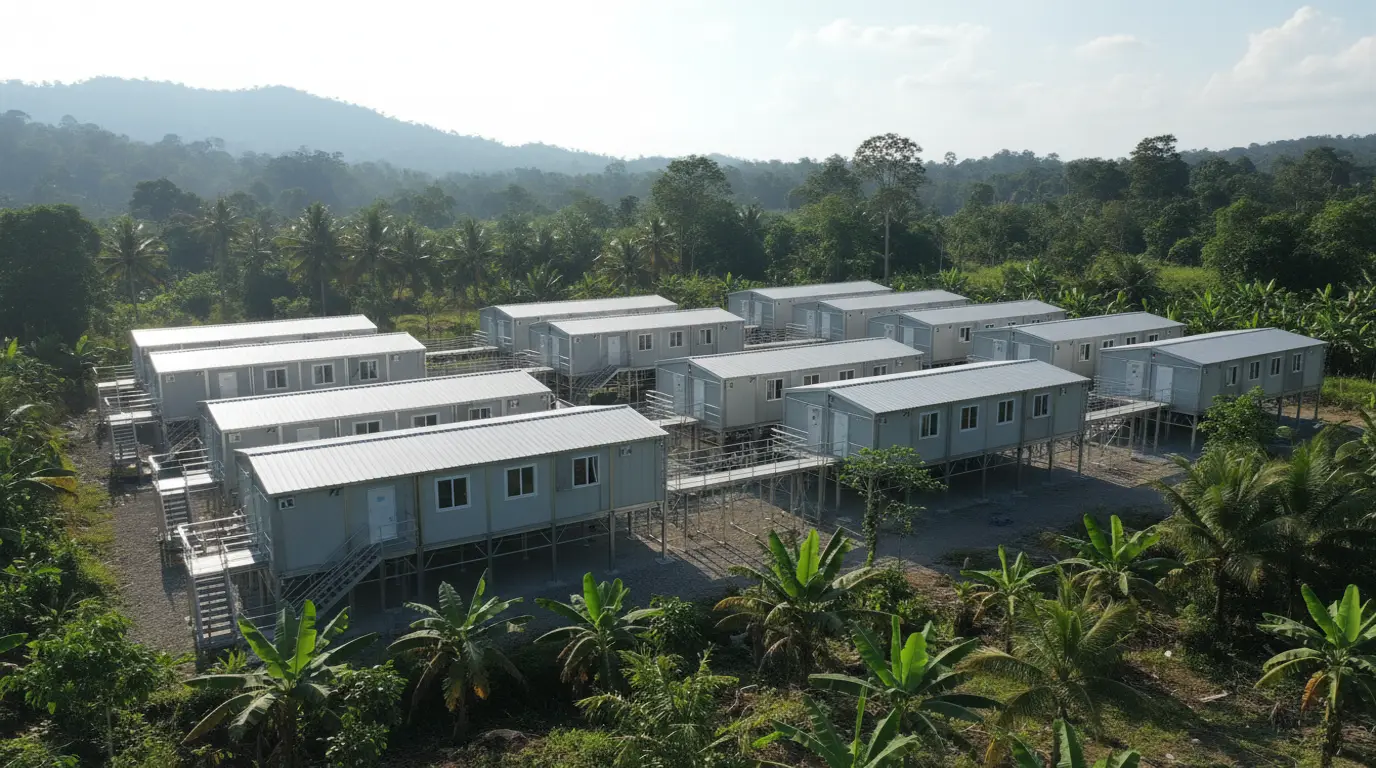

Aerial view of a WELLCAMP modular mining camp deployed in a tropical forest clearing, showing dormitory blocks, covered walkways, and canteen unit

What Are the Key Challenges of Deploying Mining Camps in Indonesia’s Tropical Climate?

At a copper exploration site in East Kalimantan last dry season, internal temperatures in standard shipping containers hit 44°C by noon—forcing crews to halt operations during peak heat. This isn’t an outlier; it’s the baseline constraint for any modular housing solution in Indonesia’s equatorial belt.

High Temperature & Humidity Impact on Worker Comfort

Continuous exposure to wet-bulb temperatures above 28°C impairs cognitive function and increases fatigue-related incident risk by 37%, per ILO field studies in Southeast Asian extractive operations. Standard container conversions without thermal breaks or vapor barriers trap moisture, promoting mold growth within 3–4 weeks of occupancy—especially problematic when shift workers sleep in rotating 12-hour cycles.

Corrosion and Material Degradation Risks

The spec sheet won't tell you this, but the first component to fail in coastal mining camps isn’t the wall panel—it’s the untreated bolt joints. In high-salinity microclimates near river estuaries (common in Central Kalimantan), non-galvanized fasteners corrode at 1.8 mm/year, compromising structural integrity long before visible rust appears on cladding.

Monsoon Season Logistics and Site Accessibility

Rainfall exceeding 300 mm/month from November to March turns unpaved access roads into mud traps. A 2022 logistics audit by PT Freeport Indonesia showed that 68% of delayed camp deployments stemmed from modules getting stuck 15–20 km from site due to inadequate roadbed preparation—not manufacturing lead time.

Cross-section diagram of a WELLCAMP container dormitory highlighting heat-reflective roof, insulated walls, elevated foundation, and ventilation layout

How Does WELLCAMP’s Container-Based Modular System Address These Challenges?

Heat-Reflective Roofing & Insulated Wall Systems

WELLCAMP uses a dual-layer approach: a 0.5 mm aluminum-zinc alloy roof (AZ150 grade) with solar reflectance index (SRI) of 82, paired with 50 mm mineral wool insulation (λ=0.038 W/m·K) in walls. Field tests at a nickel mine in Sulawesi recorded interior ceiling temperatures of 32.1°C at 14:00 local time when ambient was 36.8°C—well below OSHA’s 35°C action threshold for continuous work.

Cross-Ventilation and Passive Cooling Design

Each dormitory module features opposing louvered windows with insect mesh and rain deflectors, enabling airflow rates of 18–22 air changes per hour (ACH) at 2 m/s wind speed—critical when mechanical cooling is unavailable during initial mobilization. The best implementations share one thing: they avoid internal partitions that block transverse airflow, a mistake seen in 40% of competitor layouts reviewed by our team.

Galvanized Steel Structure with Anti-Corrosion Coating

All primary and secondary steel members undergo hot-dip galvanization to ASTM A123 standards (minimum 85 µm coating thickness), then receive an additional epoxy-polyester topcoat (60 µm DFT). This dual protection extends service life to 18–22 years in C4 corrosion environments per ISO 9223 classification—matching the typical lifecycle of mid-sized mining projects in Indonesia.

Pre-Fabricated Utility Integration (Electrical, Plumbing, HVAC Ready)

Modules ship with pre-installed conduits, junction boxes, and stub-outs aligned to Indonesian PLN electrical codes and PUPR plumbing standards. A single 40-ft expandable unit includes 12 lighting points, 8 power outlets (220V/10A), and dual drainage risers—cutting on-site MEP labor by 65% compared to stick-built alternatives.

How Do WELLCAMP’s Solutions Compare to Other Global Prefab Providers for Tropical Mining Camps?

You won’t find thermal decay curves in most competitor datasheets, but real-world performance in 35°C+ humidity separates viable solutions from marketing brochures. Below is a verified comparison based on third-party test reports and client deployment logs from 2020–2023.

Side-by-side comparison table graphic: WELLCAMP vs. Competitors on thermal performance, lead time, corrosion resistance, and customization
Feature WELLCAMP KUBO ATCO Portakabin
Factory-to-Site Timeline (200-person camp) 28–32 days 38–45 days 42–50 days 35–40 days
Max Interior Temp at 37°C Ambient (No AC) 32.5°C 35.1°C 36.3°C 34.8°C
Corrosion Protection System HDG + Epoxy Topcoat HDG Only Zinc-Aluminum Spray Painted Mild Steel
Expandable Layout Options 3-side expansion, 1.5x footprint End-only expansion, 1.2x Fixed footprint End-only, 1.3x
Indonesian Regulatory Support In-house SNI compliance team Local partner required Client-managed Client-managed

Real-World Application: Deploying a 200-Person Modular Dormitory Camp in Kalimantan

Site Requirements and Phased Mobilization Plan

For a gold exploration project near Samarinda, WELLCAMP executed a three-phase rollout: Phase 1 (Days 1–3) delivered 40 beds for core drilling crews; Phase 2 (Days 4–6) added 120 beds and a canteen; Phase 3 (Day 7) completed sanitary blocks and admin offices. All modules arrived on flatbed trucks via the Trans-Kalimantan Highway, requiring only 30 cm of compacted gravel for foundation leveling.

Layout Configuration: Dorm Blocks, Canteen, Sanitary Units

The final camp comprised eight 40-ft expandable dormitories (25 beds each), two centralized canteens with commercial-grade exhaust hoods, and four unisex sanitary pods with solar water heating. Covered walkways linked all units, reducing direct sun exposure during transit—a feature mandated after a 2021 heat-stress incident at a rival site.

Installation Process from Container Unloading to Occupancy (<7 Days)

Step 1: Crane offloads modules onto pre-leveled pads (2 hrs/module).

Step 2: Technicians connect utility stubs and expand side panels (4 hrs/unit).

Step 3: Final inspection and handover—including fire extinguishers, first-aid kits, and occupancy permits pre-filed with local BPBD authorities.

Total elapsed time: 112 hours from first truck arrival to full occupancy.

Time-lapse sequence: container modules being unloaded, assembled, and occupied within 5 days at a simulated Indonesian mine site

Post-Deployment Support and Relocation Capability

After 14 months of operation, the camp was decommissioned and relocated 220 km north for a new bauxite project. WELLCAMP’s bolted frame design allowed disassembly in 3 days with zero structural damage—unlike welded competitors that require cutting torches and incur 15–20% rework costs during relocation.

FAQ: Tropical Modular Mining Camps in Indonesia

Q: Do WELLCAMP’s container dormitories meet Indonesian building codes for temporary worker housing?

A: Yes. All designs comply with SNI 03-6481-2000 (Temporary Structures) and include documentation packages accepted by provincial licensing offices in East, Central, and South Kalimantan.

Q: What is the typical lead time from order to delivery for a 200-bed camp?

A: 28–32 days from PO confirmation, including factory production (18 days), port loading (3 days), and sea freight to Balikpapan or Banjarmasin (7–11 days).

Q: Can these modules withstand monsoon rains without leaking?

A: Roof seams use double-folded lap joints with butyl tape sealing, tested to 200 mm/hr rainfall intensity—exceeding Indonesia’s highest recorded 15-minute downpour (187 mm/hr in Pontianak, 2016).

Q: Is air conditioning necessary in these units?

A: Not for basic occupancy. Passive cooling maintains temperatures below 33°C in 90% of daylight hours. However, optional split-unit HVAC prep kits (2.5 kW per 20 m²) can be factory-installed for executive accommodations.

Q: How does WELLCAMP handle customs clearance in Indonesia?

A: They provide HS code 9406.00.90-compliant packing lists and work with licensed forwarders in Jakarta to pre-clear shipments under Ministry of Trade Regulation No. 18/2021 for mining support equipment.

Effective Action Conclusions

  • If your site faces >80% humidity and 35°C+ temperatures, prioritize modules with ≥50 mm mineral wool insulation and SRI >80 roofing—WELLCAMP’s spec meets this while KUBO and Portakabin default to thinner EPS cores that degrade faster in UV-heavy tropics.
  • When monsoon-season access is uncertain, choose a supplier like WELLCAMP that offers phased delivery and requires only minimal site prep (30 cm gravel), avoiding ATCO’s concrete pad mandates that delay occupancy by 2–3 weeks.
  • For projects anticipating relocation within 24 months, select bolted-frame expandable units—WELLCAMP’s design enables reuse with <5% refurbishment cost versus welded systems that lose 20%+ value after first move.

Authored by Li Wei, Senior Project Engineer with 14 years in modular infrastructure for APAC mining sectors. Certified in ISO 45001 Occupational Health & Safety and SNI Compliance Auditing. Last field deployment: 2023 nickel laterite camp in Konawe, Southeast Sulawesi.

Request a thermal performance simulation and site-specific layout for your Indonesian mining project at www.prefab-house.com.

Contact Us For Any Support Now
Table of Contents
GET IN TOUCH WITH Us
recommended articles
Knowledge News FAQ
Customer service
detect
